25 November 2016

Light House Progress Update

Construction on Light House continues to progress on program with the following updates as of 25 November 2016:

  • Structural core has been completed to Level 58.
  • Concrete pours to Level 56.
  • Glass and metal façade to Level 52 has been completed.
  • Joinery installed to Level 40.
  • Defecting completed to Level 27.

24 October 2016

Light House – Progress Update

Construction on Light House has made rapid progress this past month with the following updates as of 24 October 2016:

  • Structural core has been completed to Level 52.
  • Concrete pours to Level 50 .
  • Glass and metal façade to Level 45 has been completed.
  • Joinery installed to Level 35.
  • Defecting completed to Level 20.

22 September 2016

Light House – Progress Update

Construction on Light House has made rapid progress this past month with the following updates as of 22 September 2016:

  • Structural core has been completed to Level 46.
  • Concrete pours of levels o 43.
  • Glass and metal façade to Level 37 has been completed.
  • Joinery installed to level 26.
  • Defecting completed to Level 14.

23 August 2016

Light House – Progress Update

Construction on Light House Tower is progressing smoothly with the following updates as of 23 August 2016:

  • Structural core has been completed to Level 39.
  • Concrete pours of levels to Level 37.
  • Glass and metal façade to Level 32 has been completed.
  • Joinery installed to Level 19.
  • Defecting to Level 5.

26 July 2016

Light House – Progress Update

Construction on Light House Tower is progressing steadily with the following updates as of 26 July 2016:

  • Structural core has been completed to Level 31.
  • Concrete pours of levels to Level 29.
  • Glass and metal façade to Level 24 has been completed.
  • Joinery installed to level 13.
  • Amenities level (pool/gym/other) structural areas completed. Cosmetic fitout due to begin in August.

8 June 2016

Light House – Progress Update

Construction of Light House Tower is progressing at a rapid speed with the following updates as of 8th June 2016:

  • Structural core has been completed to Level 25
  • Concrete pours of levels to Level 22
  • Glass and metal façade to Level 19 has been completed.
  • Joinery installed to level 10
  • Amenities level (pool/gym/other) beginning final finishes

29 April 2016

Light House – Progress Update

We are pleased to report that construction progressed well in April on Lighthouse Tower with the following updates:

  • Concrete pour of levels to Level 17 as of 13/05
  • Core walls have reached level 19
  • Glass and metal façade has reached level 13
  • Form work has been stripped in key areas including amenities and pool located on level 8
  • Level 3, 4 & 5 installation of joinery and final finishes

30 March 2016

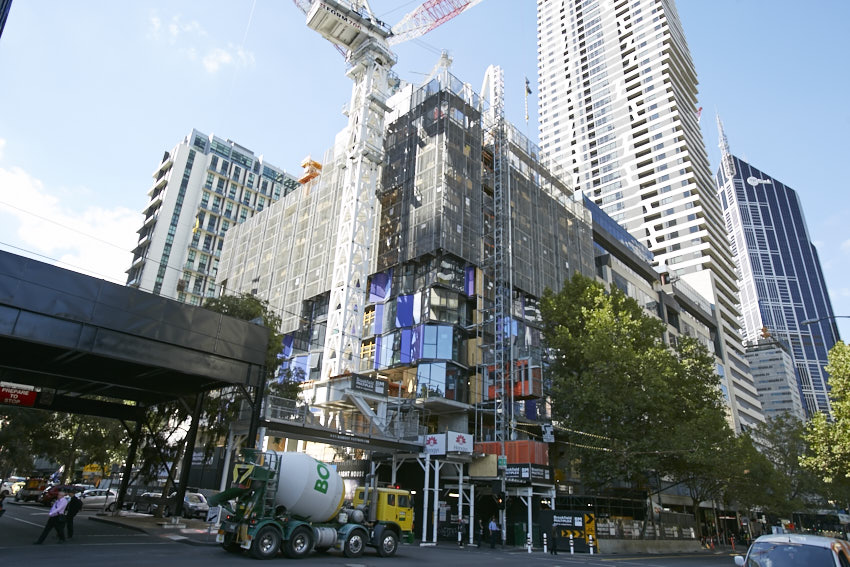

Light House – Progress Update

With construction commencing in February 2015, Lighthouse Tower, 450 Elizabeth Street is currently advancing at a healthy pace with Level 11 poured and facades up to Level 6 now completed. Core is finished to Level 14.

  • Level 9 pool slab poured
  • Façade complete to Level 6
  • Core complete to Level 14
  • Finishes Level 2 – Level 5 (in progress)
